South Okanagan - North Beach Rockslide

Last updated on August 1, 2025

Access road with Highway 97 south intersection

On August 28, 2023, Highway 97, north of Summerland, above North Beach Road was closed because of a rockslide that deposited 3,000 cubic metres of material onto the highway surface. This project will stabalize the highway and return it to four lanes.

Traffic impacts

Drivers are asked to use caution, obey speed limits and follow directions of traffic-control personnel.

  • Daily traffic control on site
  • Expected travel delays are 3 minutes or less
  • Highway 97 will remain open to two-way traffic between Callan Road and Okanagan Lake Provincial Park north of Summerland
  • The road may need to be closed again with limited notice if deemed unsafe
  • Closures are more likely during heavy rainfall or snowfall

Check DriveBC for current conditions and events.


Commercial vehicles - Oversize loads

Oversized loads are permitted Sunday, Monday, Wednesday between 9 pm and 5 am.

  • Size: Oversized loads equal to or greater than 3.8 m are permitted through the site
  • Days: Sunday, Monday, and Wednesday
  • Time: Between 9 pm and 5 am
  • Information required: Provide details of the width of the wide load for pre-planning purposes

Contact Traffic Control 24 hours in advance of your arrival on site to ensure traffic control resources are available for your passage.

Traffic Control on site
Phone: 236-990-7233
or:  778-939-7233

If no response from Traffic Control on site, contact
AIM Roads 24 hour
Phone: 1-866-222-4204

Long-term stabilization work will return the highway to its original four-lane configuration. This includes:

  • Building a retaining wall and catchment area at the base of the slope, along with a concrete wall next to the highway for added reinforcement
  • Installing additional rock anchors to secure the slope
  • Repairing the road’s surface
  • Drainage improvements

On this page

Status

  • Emil Anderson Construction Inc. has been awarded a contract for the long-term stabilization work that will return the highway to its original four-lane configuration
  • Temporary stabilization work is complete, and the site is safely shut down until long-term stabilization work begins
  • Geotechnical engineers continue to monitor the slide site for changes in ground conditions

Schedule

Construction is expected to begin in fall 2025 and finish in spring 2027.

Project cost

$23.2 million

Initial investigation

Aerial view marked with outline of tension crack location

After the rockfall event on August 28, Geotechnical engineers discovered tension cracks extending further upslope beyond the initial rockfall area.

Close up of the tension crack

The tension cracks were up to 2 m wide and up to 20 m deep, revealing that the initial rockfall was part a larger event that required mitigation to protect road users and the highway.

Short term response - reopening Highway 97

Aerial view of the temporary berm almost completed.

To manage the initial emergency, a 22 m high temporary soil and rock berm was constructed along the toe of the slide to resist further slope movement. This temporary berm acts as a buttress for holding back slide movement until long-term stabilization measures can be implemented.

Preliminary recovery has been completed. Investigations into the slide revealed tension cracks above the source area of the rockfall, indicating the presence of a larger slide

Special equipment to monitor slide movement

During the construction of the berm, a 24/7 slide monitoring program was established. Specialized survey equipment is used to continuously monitor the area for slide movement. If slide movement is detected, the highway can be closed on short notice to protect road users and site workers

Slide material removal

#

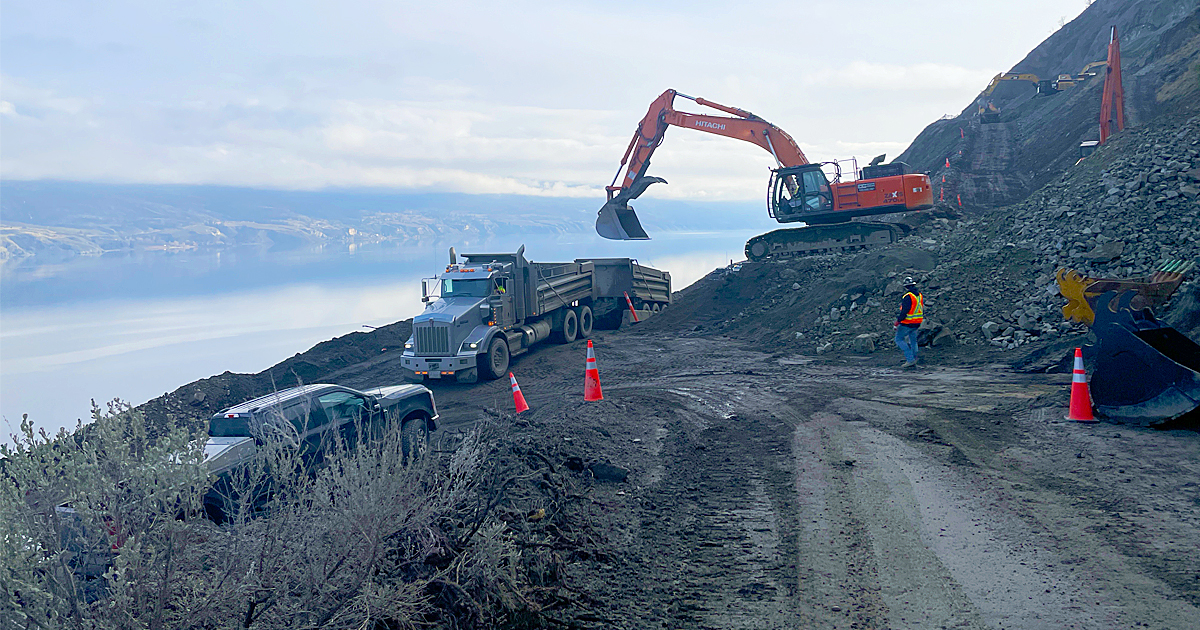

From October 2023 to June 2024, blasting operations were conducted to reduce the pressure on the hillside and protect the road from further rockfall. The unloaded material has been moved to off-site storage.

More than 46,500 m3 of material has been removed from the slope since the rockfall in August 2023.

Stabilization

Anchors

Geotehnical engineers have determined additional long-term stabilization measures are required in this area.

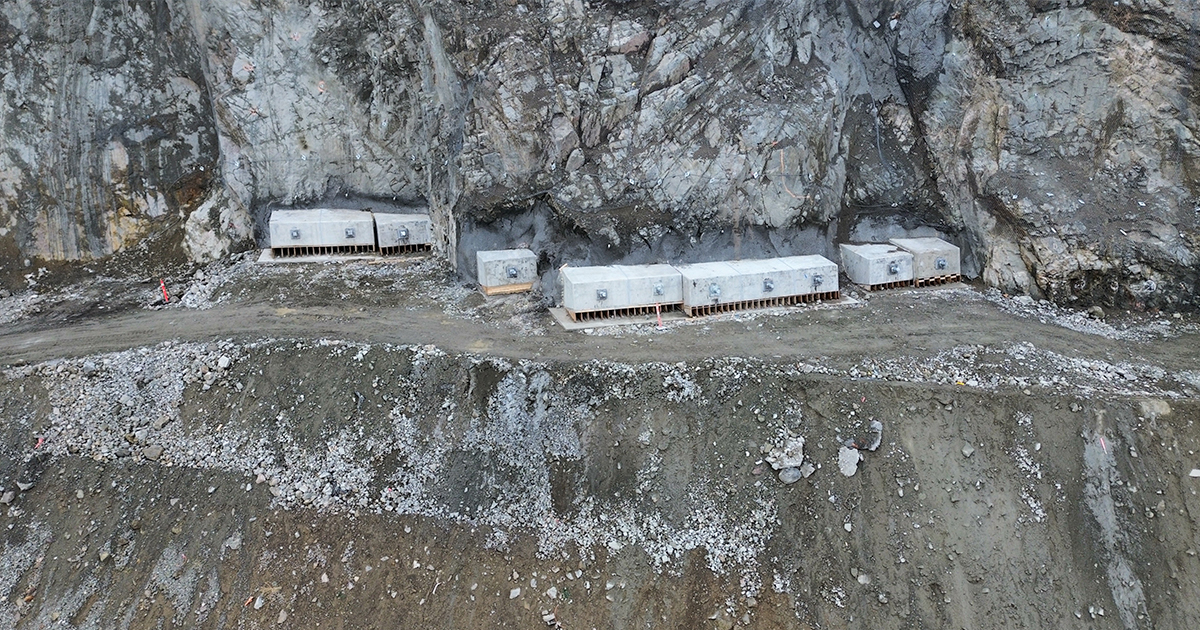

Steel rock anchors (32 mm to 75 mm thick and up to approximately 30 m in length) have been installed in the slide zone to permanently stabilize the rockslide area.

The temporary berm will be replaced by a Mechanically Stabilized Earth retaining wall, which will form a buttress to complement the anchors.

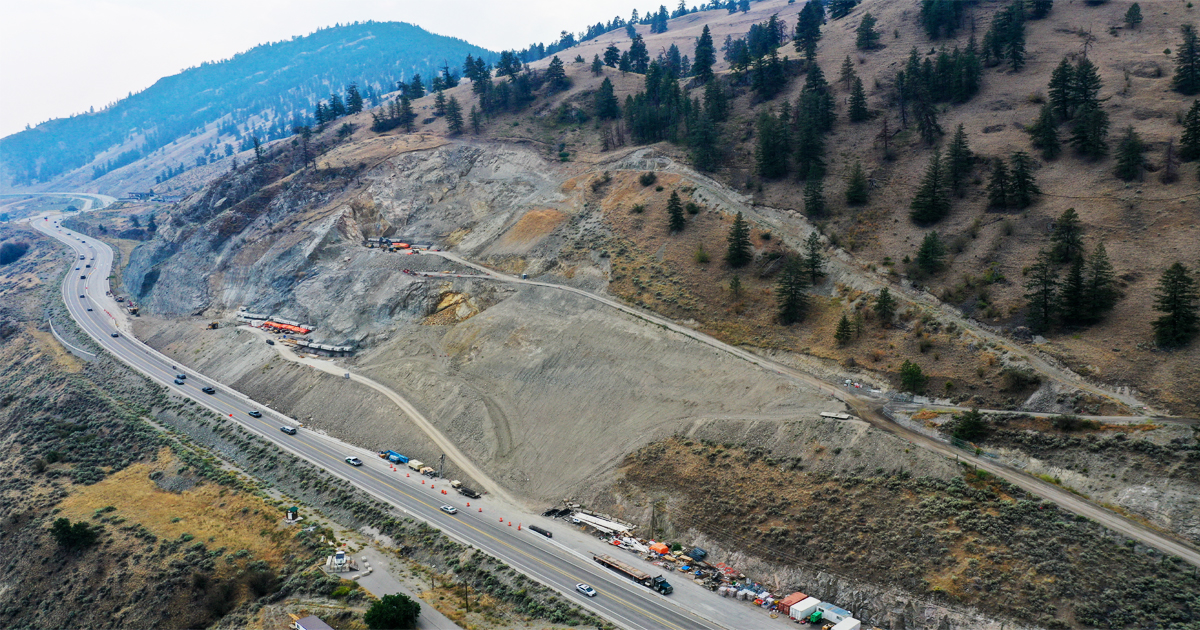

Photo gallery
